رواق برزخ تهوانتپك بين المحيطين
رواق برزخ تهوانتپك بين المحيطين Corredor Interoceánico del Istmo de Tehuantepec | |
---|---|
الإحداثيات | 17°18′00″N 94°59′24″W / 17.30000°N 94.99000°W |
المواصفات | |
الطول | 303 km (188 miles) |
الوضع | Main railway line open, two more lines planned for March and July 2024. Salina Cruz port still under construction |
سلطة الملاحة | سكرتارية البحرية |
التاريخ | |
تاريخ الموافقة | 14 يونيو 2019 |
بدء الإنشاء | 7 يونيو 2020 |
تاريخ أول استخدام | 28 أغسطس 2023 (بضاعة) 17 سبتمبر 2023 (ركاب) |
تاريخ الاكتمال | 22 ديسمبر 2023 (سكة حديد) |
الجغرافيا | |
نقطة البداية | سالينا كروز، واخاكا |
نقطة النهاية | كواتساكوالكوس، ڤيراكروز |
تتصل بـ | Pacific Ocean from Atlantic Ocean and vice versa |
رواق برزخ تهوانتپك بين المحيطين (إسپانية: Corredor Interoceánico del Istmo de Tehuantepec), abbreviated as CIIT, is a trade and transit route in Southern Mexico, under the control of the Mexican Secretariat of the Navy, which connects the Pacific and Atlantic Oceans through a railway system, the Ferrocarril del Istmo de Tehuantepec, for both cargo and passengers, crossing through the Isthmus of Tehuantepec. This project also consists on the modernization and growth of local seaports, particularly the ports of Salina Cruz (Oaxaca) and Coatzacoalcos (Veracruz), and of the es (Minatitlán oil refinery) and the es (Salina Cruz oil refinery). In addition, it plans to attract private investors through the creation of 10 industrial parks in the Isthmus area, as well as two other parks in Chiapas. The project has the goal of developing the economy and industry of the Mexican South through encouraging economic investment, both national and international, and facilitate commerce and transportation of goods internationally.[1]
Initiated under the presidency of Andrés Manuel López Obrador, it has been widely regarded by analysts as his most important project, as it has the potential to offer a long-term boost to the Mexican economy and develop the industry and economy of the South, which has notoriously been one of the poorest regions of the country for decades. It has the potential to be an alternative "cheaper and faster than the Panama Canal."[2]
The project consists on the rehabilitation of the Tehuantepec Railway, which finished construction during the presidency of Porfirio Díaz in 1907, which was built with similar goals, but started to fall out of use upon the outbreak of the Mexican Revolution and the opening of the Panama Canal in 1914. It also will modernize the ports of Salina Cruz, which opens to the Pacific Ocean, and Coatzacoalcos, to the Atlantic. As part of the project, 10 industrial parks will be built in the area surrounding the railway to encourage economic investment and industrial development in the region.
On 18 September 2023, the current director of the CIIT, Raymundo Morales Ángeles, announced that the Corridor's freight services on the Coatzacoalcos-Salina Cruz line (Line Z) officially began "from this very moment", and that the Coatzacoalcos-Palenque line (Line FA) began that same month. Line Z was officially opened for passengers on December 22, but cargo operations have been delayed.
. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . .
التاريخ
خلفية
Plans to connect these two oceans through the Isthmus of Tehuantepec had existed since the Colonial period in the 16th century, with plans to build a canal or highway in the site being considered, but never successfully executed. As early as the first half of that century, during the early years of the existence of the Viceroyalty of New Spain, the Spanish colony which is now Mexico, the Spanish conquistador Hernán Cortés had already expressed his interest in creating communication between the two oceans in his letters to Charles V, Holy Roman Emperor, though this doesn't necessarily mean he conceived the idea of using the Isthmus for this purpose.[3] Due to the short distance between the two oceans in this area, the potential for the creation of such a project had been attractive to various global powers, including Spain, England, France, the Netherlands and finally the United States, as it would've saved costs, time and, especially during the 19th century, lives and products, as it would've reduced the risk of losing cargo ships attempting to reach the other side of the Americas.[4][5]
Alexander von Humboldt wrote in his Political Essay on the Kingdom of New Spain, published in 1811, that the Isthmus of Tehuantepec was ideal for the creation of a canal to connect the Pacific and Atlantic Oceans, due to the proximity between the ports of Vera Cruz and Tehuantepec, finding that the Isthmus between them is the narrowest point between the two oceans in New Spain, and due to the proximity of the sources of the Coatzacoalcos and Chimalapa rivers, which discharge into the Gulf of Mexico and the Pacific Ocean respectively. In the Essay, he mentioned multiple points in the Spanish Americas where the two oceans could be connected, including the Isthmus of Panama (belonging to the Viceroyalty of New Granada), remarking the fact that Vasco Núñez de Balboa successfully crossed it as early as 1513 (several years before Mexico was conquered by Spain), but that since then, at the time of the work's publication, no survey of the region nor the determination of its exact geographic position had been made, despite propositions being made since 1528 suggesting cutting that Isthmus and joining the sources of local rivers.[6]
Indeed, he also remarked that Viceroy Juan Vicente de Güemes, 2nd Count of Revillagigedo, "has been for a longtime occupied" in the project of the creation of such a canal, and that land-based roads had been opened in the Isthmus since the late 18th century, which created commercial communication between the two oceans; these were used, he remarked, to transport "the most precious of all known indigoes," the indigo from Guatemala (then a kingdom belonging to New Spain covering much of Central America, bordering Panama, though, according to Humboldt, it "depends very little on the viceroy of New Spain"), and cacao from Guayaquil (in modern-day Ecuador, then part of the Real Audiencia de Quito) to Acapulco and, from there, to Vera Cruz to be sent to Europe, so as to avoid the dangers and difficulties of navigation to and through Cape Horn.[6] He remarked in the Essay the natural beauty and rich resources of the intendancy of Oaxaca, where Tehuantepec is located, and stated that the port "will become one day of great consequence when navigation in general, and especially the transport of the indigo of Guatimala, shall become more frequent by the Rio Guasacualco [ك]."[7]
In 1774, the Spanish authorities conducted geological research in the Isthmus and issued a decree allowing their colony to create a canal in 1814, but this would not occur until Mexico became an independent country in 1821. Shortly after the independence, the Mexican government conducted its own surveys in the region, which resulted in the survey teams proposing the idea of the construction of a railroad, though this wasn't done due to Mexico's economic crisis of this period.[8]
المحاولات الأولى لربط المحيطين الهادي والأطلسي عبر برزخ تهوانتپك
Mexico had seen the commercial opportunities brought by railway systems since the early years of this industry. Just 7 years after the Liverpool and Manchester Railway was opened in England, Mexican President Anastasio Bustamante, on 22 August 1837, offered a concession to a man from Veracruz named Francisco de Arrillaga with the purpose of building a railway line between Mexico City and Veracruz. Under this concession, the railway was to be finished in 12 years and no other entity was allowed to build a railway between the two cities in 30 years. Though nothing would come about this concession, the Mexican government would continue to try to connect the ports of Veracruz with the country's capital and the Pacific Ocean.[9]
امتياز گاراي وشركة نيو أورلينز

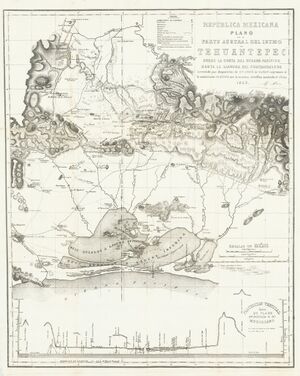

No serious attempts to construct the corridor would be made until 1842, during the provisional government of Antonio López de Santa Anna, when plans were made to build an interoceanic communication line in the Isthmus (though no such line would be built). The task to achieve this was given to a businessman named José de Garay on March 1 of that year, who would be entitled to collect tolls for its usage for 50 years, paying 1/4 of the profits to the Mexican treasury, and to own uncultivated land stretching 55.7 km (34.6 mi) toward either side of the route, on which he could establish worker colonies. Garay was to conduct, at his own expense, a survey of the region within 18 months at most and the construction of the communication line had to begin within the following 10.[5]
Though the idea of a railway was the one initially proposed and which would be ultimately executed, the lead engineer, the Italian-born Gaetano Moro, advocated for the creation of a ship canal with 150 locks instead, estimating the cost of its construction at the "woefully optimistic" sum of nearly £3.4 million pounds sterling (roughly $13.5 million US dollars), using the Caledonian Canal, in Scotland, as a model. The "Canal of Tehuantepec" proposal "differs in no extraordinary degree [...] from similar works already executed in Great Britain, France, Holland, or the United States," as an account of the project published in 1846 stated. The proposal was to join the waters of the Ostuta River with the Chicapa River nearby, which discharge into es (Laguna Inferior) and es (Laguna Superior) respectively, using trenches, then deliver the waters to the site of Tarifa, and from there create the canal using the nearby rivers, such as the Tarifa, Chichihua and Malatengo to the Gulf and the Chicapa to the Pacific.[10] Garay was officially given the land the concession granted him in March 1843 after delivering the results of the survey, being secured by the Minister of Foreign Affairs and Home Department José María Bocanegra. However, the concession would have expired in July 1844 since the project fell stagnant due to a lack of funds (despite getting access to free labor from three hundred convicts in October,[11] also secured by Bocanegra), but Garay asked for a two-year long renewal a few days before the deadline.[12][5]
Garay understood that solely with Mexican capital the project could not be fully funded, thus he traveled to London, England, in 1844 (where he also published the results of his survey) in hopes of finding investors. Though initially unsuccessful due to hostilities breaking out in May 1846 between Mexico and its northern neighbor, the United States, he managed to renew his grant for two years in November 1846, during the administration of José Mariano Salas, after ceding the lands and privilege to build the communication line in August to the Mexico City-based firm of Manning and Mackintosh; owned by Robert Manning and Ewing C. Mackintosh, representatives of British bondholder committees in Mexico;[13] and to the London-based Schneider & Co., Schneider being an English consul involved in the exploitation of mahogany in the Isthmus. This agreement was ratified in 1847. Throughout the year of 1848, however, Manning and Mackintosh, along with Garay, attempted to sell the concession to the British and United States governments, and then to private U.S. citizens after failing to do so. 18 months would pass without any notable advancements in the project, despite Manning insisting the contrary in early 1849.[5]
As these firms disputed with the Mexican government over the validy of this agreement throughout the months following the purchase, they started to look for investors from the United States, as, upon the aftermath of the Mexican–American War, demand from American businesses to connect the East and West Coasts through Mexico with benefits from the defeated Mexican government increased, as the war resulted in Mexico ceding the state of California to the U.S., in the American West Coast. Additionally, the discovery of gold in California further increased demands, turning the previously limited commerce of the Mexican Pacific coast into a highly sought-after industry.[5] The U.S. had expressed great interest on the Isthmuses of Tehuantepec and Panama for years before, and throughout the course of the Mexican–American War, as U.S. troops approached the Mexican capital, U.S. politicians insisted that a peace treaty should be negotiated which granted their country the right to use the Tehuantepec route. For example, Nicholas Trist, who negotiated the peace between the two countries, attempted to purchase, as he was instructed, the right of "passage and transit" through the Isthmus for $15 million dollars, but failed as the Mexican government announced in September 1847 the existence of the Garay grant and the subsequent purchase of it by Manning and Mackintosh. Trist continued to insist, but ultimately failed at his objective and no mention of the right of passage through the Isthmus of Tehuantepec was included in the Treaty of Guadalupe Hidalgo, signed on 2 February 1848 to end the war.[14] In February 1849, the British firm sold Garay's concession to a New York City businessman named Peter A. Hargous (speculatively for a modest amount), who proceeded to attract attention from investors through soliciting articles to major newspapers across the American East Coast and the South, and, collaborating with Garay, through a general railroad convention held in October in Memphis, Tennessee. Through these efforts, they managed to attract the attention of wealthy businessmen from New Orleans, Louisiana, at the time the most important city in the South of the U.S., who proceeded to publish an article in The Daily Picayune addressing the Tehuantepec route, offering attractive, albeit exaggerated and at times inaccurate, descriptions of the site, immediately attracting the attention of the city's business elite.[15]
In 1850, Hargous approached Judah P. Benjamin, a member of the Louisiana House of Representatives, to negotiate the purchase of the Garay grant with the New Orleans businessmen. Benjamin and the businessmen formed The Tehuantepec Railroad Company of New Orleans (TRCNO), of which Benjamin became chairman,[15] which would later become known as the Louisiana Tehuantepec Company. Hargous gave the company a $500 thousand dollar loan and the company sought to raise $9 million in capital. The Mexican government became aware of the deal with the New Orleans company on December 30, five days after Major John G. Barnard, lead engineer of the U.S. survey team composed of 54 engineers, arrived at the river mouth of Coatzacoalcos, Minatitlán.[16] However, the Mexican government had doubted the validity of Garay's concession for some time: in March 1849, after Manning's futile attempt to demonstrate that works for the construction of the interoceanic line had been active, the government declared that Garay's concession had expired in November of the previous year, a declaration which the British firms protested against until they handed the issue over to Hargous in July.[5]
The situation would get more complicated henceforth. Hargous, soon after purchasing the Garay grant, promoted the advantages of the Tehuantepec route to the U.S. Senate and asked for diplomatic support. This resulted in the U.S. Ambassador to Mexico Nathan Clifford, as instructed by U.S. Secretary of State John M. Clayton, addressing a threatening note to the Mexican government to not annull the Garay concession based solely on it being possessed by a U.S. citizen, stating that "If such should be the fact, the measure could not fail to be regarded by the President of the United States as proof of a disposition wholly at variance with the existing pacific relations between the two countries." In an attempt to cool tensions, a treaty to guarantee the right of Hargous was negotiated in September 1849 between Ambassador Robert P. Letcher, under orders of Secretary Clayton, and former Mexican President Manuel Gómez Pedraza. This treaty was ultimately signed on 22 June 1850, though with some changes that ensured the neutrality of the route and limited U.S. intervention.[11] While this did not completely break relations between the U.S. entrepreneurs and the Mexican government, it foreshadowed the diplomatic tensions which would ultimately cause the project's failure. Despite the tensions, the company started making preparations for their own survey of the Isthmus in April 1850, soon after the company's formation. In June, despite it being the rainy season in the Isthmus, a local engineer named P. E. Trastour was sent to the Pacific Coast to conduct a survey, delivering his preliminary report in October despite facing much hardship. In December, Major John G. Barnard, whose services had been offered to the company by U.S. President Zachary Taylor, was sent with his own survey team.[17] Barnard's team found that "no difficulties exist in the way of constructing a railroad over those divisions which lie on either side of the dividing ridge" and that the survey's results "will satisfy the most skeptical that the project of constructing a railroad or transit route to connect the two oceans, is not only eminently feasible, but practicable." Additionally, due to the distance saved while traveling to the American West Coast from New Orleans, New York or England, the report claims that it "is therefore plain that the superiority of Tehuantepec over all other routes is immeasurably great."[16]
However, the aggresivity of the U.S. Secretary of State Daniel Webster would create a diplomatic disaster in January 1851. He demanded the Mexican government to give the U.S. Military more freedom to intervene in the Isthmus in the interest of U.S. citizens. Mexican President Mariano Arista countered these demands claiming that no agreement would be reached if the U.S. did not recognize Mexico's right to choose who operates on the Isthmus and under what conditions they could do so. U.S. President Millard Fillmore attempted to cool tensions, and a treaty was drawn which attempted to find a middle ground between the U.S. demands and Mexican defense. The terms of the treaty were well approved by Hargous and the U.S. Congress, but not in the Mexican Congress, which proceeded to investigate the validity of the Garay concession, against the desires of Hargous and Webster. The Mexican Senate came to the conclusion that the Garay concession was illegal because it was given under a provisional government and wasn't submitted for approval to Congress before April 1845, thus the New Orleans company had to obtain a concession of its own if it wished to continue the project. As Hargous responded to this with hostility, on 15 May 1851, Benito Juárez, then governor of Oaxaca and future president of Mexico, commanded for all United States citizens in the state to be detained under orders of President Arista, who then proceeded against the engineers of the Barnard survey, ordering them to leave the country immediately. The project had been terminated.[18]
. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . .
المزيد من المحاولات من لويزيانا (1853-1861)
هذا القسم فارغ. بإمكانك المساعدة بأن تضيف إليه. (December 2023) |
مشاريع أخرى
In 1859, during the administration of Benito Juárez, the Mexican and United States' governments signed the McLane–Ocampo Treaty. The treaty, if ratified, would've given the United States the right to make full use, "in perpetuity," of the Isthmus of Tehuantepec, though this never occurred as the treaty was never ratified. This treaty remains controversial to this day, as Mexicans continue to consider that the signing of it almost made the nation lose its sovereignty. This controversy would, in fact, continue to cause debate when plans were made to create an interoceanic corridor through the Isthmus of Tehuantepec in the 1990s.[19]
On 31 May 1842, nearly 2 months after Garay received his concession, López de Santa Anna authorized the committee of creditors in charge of maintaining the road between Perote, Veracruz, and the port to build a railway to connect the port with the river of San Juan. This railway, 11.5 km (7.1 mi) long, built with the assistance of Belgian personnel and using English materials, was inaugurated on 16 September 1850, making it Mexico's first ever completed railway. In 1853, the government would offer another concession to British subject John Laurie Rickards to build a railway between Mexico City and Veracruz, though the concession was invalidated about two years later and a concession was given to the Masso brothers, on 2 August 1855, to build a railway from Acapulco to San Juan, passing through Mexico City. On 4 July 1857, under President Ignacio Comonfort, the line from Mexico City to Villa de Guadalupe was inaugurated, which would form part of the Mexico City–Veracruz line the government had been attempting to create for nearly two decades by this point. Works were suspended shortly thereafter and the concession was given on August 31 to a businessman from Orizaba named Antonio Escandón, who also purchased the Veracruz–San Juan line.
Works to build the Mexico City to Veracruz line officially began late in that year. In spite of facing great difficulties over the following years, due to the War of Reform and the Second Franco-Mexican War, the Mexico City–Veracruz line was finally inaugurated in January 1873, under President Sebastián Lerdo de Tejada, who assisted the ceremony, concluding nearly 36 years of work to finish the line that would connect the capital with the most important port in the country for international commerce. This railway became known as Ferrocarril Mexicano, the predecessor to the Tehuantepec Railway built under President Porfirio Díaz, which would lay the foundation for the Interoceanic Corridor.[9][20]
سكة حديد تهوانتپك والمشاريع اللاحقة
Despite the failure of the previous attempts and controversial events surrounding the usage of the site, businesses and the government continued to show their interest in the creation of a communication line between the two oceans through the narrow Isthmus, and so, during the presidency of Porfirio Díaz, himself a man from Oaxaca, the project of a railway in the Isthmus of Tehuantepec would start to get shape, this time insuring the neutrality of the passage and that the Mexican nation would preserve its sovereignty, now that it enjoyed political stability and had a strong standing army, which was respected internationally due to its victories during the country's wars against Spain and France.[4] Under previous administrations, the construction of Mexican railways had been largely inefficient, as nearly all Mexican railways, with the exception of the Ferrocarril Mexicano, were limited to small lines, as many concessions expired due to results remaining undelivered. Díaz sought to combat this issue through "very liberal" concessions which resulted in most of Mexico's current railway lines being built.[9]
In 1878, an American company formed by a man named Edward Learned proposed being in charge of the construction of the railway, starting it in the year 1880, but due to considerable delays in its construction—just building 35 km (22 mi) in about two years, less than the agreed amount—the contract expired in August 1882. The task was then given to a man named Deflín Sánchez, who managed to build 76 km (47 mi) by April 1888, but there were still two thirds yet to be built. A contract was then given to Edward McLurdo, but he died before the contract could be carried out. The agreement, however, was taken by his widow in January 1892. In February, the government made an agreement with a firm of three contractors, Hampson, Chandos S. Stanhope and Corthell. It was originally planned for them to finish the railway by September 1893, but due to a lack of funds they were unable to do so. However, in December a new contract with Stanhope was signed to finish the work in nine months.

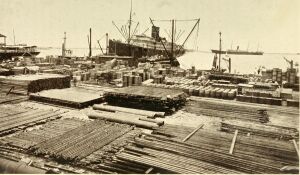

The Railway was completed in 1894, its first train passing through it in September of that year in a ten-hour long trip, starting at Coatzacoalcos at 6 in the morning and finishing at Salina Cruz at 4 in the afternoon. It officially opened in 1895. However, its quality was not sufficient enough for interoceanic traffic, so the Railway couldn't be used to link the oceans yet. In 1896, a private English company was authorized to be contracted to finish the construction of the Railway, S. Pearson & Son, Ltd., (today known as Pearson plc, then a construction company) owned by Sir Weetman Pearson, Bt, which already had experience in infrastructure in Mexico, having built Mexico City's sewage system before. This would be done, however, with intervention and participation from the Mexican government. The company would be in charge of modernizing the railways, the building of a telegraph system, two new ports; Salina Cruz, Oaxaca, to open up to the Pacific Ocean, and Coatzacoalcos, Veracruz, to the Atlantic; and of maintenance and administration.[3][4]

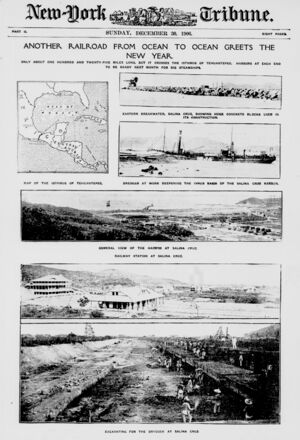

Finally, on 23 January 1907 the Railway, along with the ports of Salina Cruz and Coatzacoalcos, were inaugurated by President Díaz, the inauguration being celebrated with the transportation of 11,500 tons of sugar from Hawaii from the USS Arizonan (not to be confused with the USS Arizona (BB-39)), followed by two Japanese ships. Up until that point, the American-Hawaiian Steamship Company had been using the Strait of Magellan to transport cargo from New York City to Honolulu and other ports in the Pacific. It then had signed a contract ensuring 500,000 tons of sugar to be transported through the Tehuantepec Railway.[3] For the first six years, the Railway seemed to be highly successful, and provided a significant economic boost to Mexico. Throughout that period, it transported over 850 thousand tons of cargo across the two oceans. Throughout the construction of the railway the towns in the Isthmus area enjoyed considerable economic growth, to the point that the cities of Tehuantepec and Juchitán de Zaragoza had a larger economically active population in 1890 than the national average, only surpassed by the Distrito Federal (today known as Mexico City). In addition, Coatzacoalcos transitioned from a small village of fishermen within Minatitlán to its own municipality in 1881.
However, this success was only temporary, as the usage of the Railway began to plummet in 1914, when the Panama Canal was officially opened. Due to the profits made out of the shipment of products from New York to Honolulu or any other port in the Pacific, American businesses found it much more convinient to not let that business fall into the hands of the English or the Mexican government, thus they quickly started to go through Panama instead, driving away the Railway's main source of profit. In that year, the cargo of the Railway fell by a third, and in the following year by 77%. In addition, a few years earlier, in 1910, Mexico became engulfed in its largest civil war in history, the Mexican Revolution. Railways across the country started to be used almost exclusively for war, the Tehuantepec being used, as its usage plummeted, to transport Carrancista revolutionary troops and oil for ships.[4]
During the presidency of Ernesto Zedillo, in the 1990s, a plan was made to modernize the ports of Lázaro Cárdenas and Coatzacoalcos, and to build a highway and railway between the two, but due to budget issues the plan was never executed.[21][19] Plans to develop the economy of the Mexican South have been made since then. Under the administration of Enrique Peña Nieto, a plan was made to develop the economy through the creation of seven areas known as Special Economic Zones (Zonas Económicas Especiales, "ZEE" by its initials in Spanish and "SEZ" in English), but, as the project kept being postponed until 2017, the penultimate year of his presidency, little could be done regarding this. This project also came under criticism for a lack of budget for the infrastructure, for being "too ambicious" (though the current Corridor project has been found to be equally as ambitious), for its Zones being vulnerable to dispersion, among other reasons, though it did attract a certain degree of investment which would've produced several thousands of jobs.[22] Though many Mexican Presidents have had plans to start building the Corridor again, this would not occur until the beginning of the presidency of Andrés Manuel López Obrador in 2018, who, as a man from the southern state of Tabasco, made the development of the Mexican South a priority of his government.[23][24] In March 1995, the private sector became allowed through a constitutional amendment to participate in the provision of railroad services. In 1999, the state-owned company Ferrocarril del Istmo de Tehuantepec, S.A. de C.V., (FIT) was founded to operate the railway that connects Salina Cruz with the locality of es (Medias Aguas), Veracruz. Through this company, the construction of the modern Corridor would be made.[25]
. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . .
الرواق المعاصر
A project was presented on December 23, 2018, called "Program for the Development of the Isthmus of Tehuantepec," with the purpose of "developing the economy of the region respecting its history, culture and traditions," with Rafael Marín Mollinedo, who would later be assigned as the first director of the Corridor, being in charge of the project, proposing the creation of the Corridor, then known as the Interoceanic Multimodal Corridor (Corredor Multimodal Interoceánico).[26]
The Corridor project started development in the year of 2019, with the purpose of developing the economy and infrastructure of the area of the Isthmus of Tehuantepec in the Mexican South, which had faced social and economic stagnation for decades due to "inadequate public policies, official disinterest and decades-long exclusion of the public investment budgets, which lead to disinterest from private investment to the development of the region and its subsequent stagnation and deterioration," as the first official report of the project stated, on September 17 of that year.[27] The Corridor project was officially created on 14 June 2019, according to the decree published in the Official Journal of the Federation on that day, as a decentralized public organization.[28] Ten days after its official creation, López Obrador assigned Rafael Marín Mollinedo as the first general director of the project.[29]
In that same year, in April, López Obrador officially cancelled the project of the Special Economic Zones, under the statement that it failed to fulfill its promised benefits, despite that it had a relatively promising development in 2018.[22] However, as Baker Institute researcher Adrian Duhalt stated, the Corridor project has a wider range of impact than its predecessor, since it will cover an area of 79 municipalities in Veracruz and Oaxaca, while the SEZ only covered a handful of municipalities near Salina Cruz and Coatzacoalcos.[24]
Works for the rehabilitation of the Tehuantepec railway started in June 2020. It was reportedly expected that a cargo train would be able to move at a speed of 70 km/h (43 mph), increasing their speed from the prior 20 km/h (12 mph), and that passenger trains would be able to move at a speed of up to 100 km/h (62 mph).[30] López Obrador later stated that passenger trains will actually move at a speed of up to 80 km/h (50 mph).[31] According to the Fifth Government Report of the presidency of López Obrador, works for the modernization and expansion at the port of Salina Cruz through the construction of a breakwater started in January 2022.[32]
According to the advancement report published on 14 February 2022 by the FIT on social media, amongst the activities that have been carried out for the modernization of the Tehuantepec Railway and the port of Salina Cruz are: the construction of the breakwater by pouring hundreds of thousands of tons of rock into the sea, the removal of old rail tracks, the distribution of basalt with the assistance of a work train, the replacement of old wooden sleepers and the application of exothermic welding to fix the tracks.[33] In a controversial instance, in July 2023, it was announced that 200 trees would be cut down in the municipality of Salina Cruz for the construction of the Corridor, without offering much other information, at that time, about the business involved in the operation (later identified as ABCD ARQUITECTURA S.A. DE C.V., which is also responsible for the construction of the Coatzacoalcos railway station)[34] or its environmental impact despite the requests of local communities,[35] though the municipal council did agree to requests to spare some of the trees depending on their age, size and location, and to form a strategy to avoid massive deforestation.[36] The process to cut these trees began on August 8, though reportedly the business involved "has made the environmental compensation, in accordance to the income law."[37] The environmental impact of the Corridor has continued to be a source of concern for various communities in the Isthmus region.
In late November 2022, Marín Mollinedo announced his intention to step down from his position as director of the CIIT, to become the head of the es (National Customs Agency of Mexico), a request which became effective before December 15. His replacement became Raymundo Morales Ángeles, viceadmiral of the Mexican Navy who earned a degree in naval engineering in 1989, aside from decades of studies in both national and international institutions.[38] By decree, the CIIT has been under the control of the Mexican Secretariat of the Navy since March 2023.[39]
On the early morning of 19 May 2023, with the permission of a presidential decree, the Mexican Armed Forces took control of 127 km (79 mi) of the railways belonging to Ferrosur, a company owned by the conglomerate Grupo México, in Veracruz, sparking controversy. This portion is vital for the creation of the Corridor, since it connects the locality of es (Medias Aguas) with the port of Coatzacoalcos, completing the connection between the Pacific and Atlantic Oceans which the projects seeks to achieve. This event initially caused a dispute between Grupo México and the Mexican government. A few days after the event, various newspapers erroneously reported that the government accepted paying Grupo México 7 billion pesos in compensation, less than the 9.5 billion which the owner of Grupo México Germán Larrea Mota-Velasco had asked for, but this was denied by López Obrador on a morning press conference on May 24, stating that negotiations were continuing.[40] On the night of May 31, this issue was resolved when the two parties reached an agreement. Under the agreement, instead of financially compensating the occupation, the concession of the railway, which possesses the occupied sections, in favor of Ferrosur granted by the government on 14 December 1998 will be extended by eight years so that it remains in force until the year 2056. According to Ferrosur, the FIT will be solely responsible for "the optimal safety conditions and the costs and expenses derived from the operation and maintenance of the track, slopes and yards in the aforementioned sections. We will only have to cover the fee corresponding to the right of way."[41][42]
On 21 March 2023, director Morales Ángeles reported that the rehabilitation of the railway that connects Oaxaca and Veracruz had been 79% completed.[43] The Fifth Government Report stated that by June 2023 the railway had an accumulated physical progress of 90%, while the breakwater of the port of Salina Cruz was at 30%.[32] In late May 2023, the government declared that the Transisthmian Railway, one of the key elements of the project, has almost finished construction and estimated its inauguration at August or September 2023 and that will begin operating at full capacity in December,[44] by which point the government expects to inaugurate all other infrastructural projects of the Corridor, as the governor of Oaxaca Salomón Jara Cruz stated on a press conference in late June.[45]
أول الاختبارات
On August 13, the third day of a supervision tour through the Corridor, López Obrador was presented with the first locomotive of the Interoceanic Railway, which was named Tehuana.[46] Later, on August 26, what was formerly a tourist train in Puebla was received in Veracruz to serve as a passenger train for the Corridor, as the government of Puebla shut down its services in 2022 due to the high costs of its maintenance and operation, having spent hundreds of millions of pesos from 2016 to 2021 only to return less than 5 million.[47][48] On August 21, López Obrador stated that he expects the Salina Cruz—Coatzacoalcos passenger train line (Line Z) to be ready by September 17, while, as he announced on July 21, the Coatzacoalcos—Palenque line (Line FA) will be ready by the end of the year or, at its latest, in March 2024.[49]
On Monday August 28, the Corridor started its first test on the rehabilitated tracks, transporting 10 hoppers containing cement and 2 tanks of hydrofluoric acid from Medias Aguas to Salina Cruz. Crowds of locals gathered around the Tehuana with cheers and applause, as it was the first time the tracks had been used in over 25 years, since President Ernesto Zedillo privatized the railway sector, and as they expect for the Corridor to become an economic driver for their communities.[50][51][52] On Saturday September 9, the passenger train was tested for the first time for a full interoceanic trip, from Coatzacoalcos to Salina Cruz, starting at 6:00 in the morning and arriving at its destination at 2:20 in the morning of the next day, with no issues reported at any point of the route.[53][54] On September 17, President López Obrador made his first official trip on the Corridor's passenger train from Salina Cruz to Coatzacoalcos. He boarded the train along with the Governor of Oaxaca Salomón Jara Cruz, the Governor of Veracruz Cuitláhuac García Jiménez, and members of his cabinet, including the head of the Secretariat of the Navy José Rafael Ojeda Durán. López Obrador made a post on X (formerly Twitter) featuring a video showing gathered locals and construction workers cheering and applauding as he waves at them through a window.[55] Political figures such as former Head of Government of Mexico City Claudia Sheinbaum and Governor Jara Cruz referred to the event as a historic moment.[56] López Obrador arrived at Coatzacoalcos after a nearly 9-hour-long trip, exiting the Salina Cruz station at 10:35 and arriving at Coatzacoalcos at 19:30. Reportedly hundreds of citizens waited for his arrival for hours to welcome him.[57]
On the morning press conference of the following day, general director Morales Ángeles offered details on the beginning of the Corridor's operations: the Ixtepec, Oaxaca, to Ciudad Hidalgo, Chiapas, line (Line K) will be the last to begin operation, in July 2024. Passenger operations for Line FA will begin between December 2023 and March 2024. Passenger operations for Line Z, the interoceanic line, will begin in December 2023. Cargo operations for Line Z and Line FA officially began in September, "from this very moment" he claimed.[58][59] On October 14, López Obrador made a second official trip through the Corridor, also accompanied by Ojeda Durán. He posted a video on X recorded during this trip in which he announced that the opening of the Corridor will take place on December 22, as a few technical details are yet to be polished. He also announced that the passenger train will move at a speed of up to 80 km/h (50 mph). The trip, from Coatzacoalcos to Salina Cruz, lasted 7 hours, about the same amount of time as a bus trip, though he stated in the video that the train will be faster.[31]
الافتتاحات
On Friday December 22, passenger operations for Line Z were officially inaugurated. The inauguration ceremony in Salina Cruz—held shortly after the inauguration of the Maya Train, another flagship project of López Obrador's administration—was attended by various government officials, including the governors of Oaxaca, Veracruz and Tabasco, and military personnel, ambassadors from the United States and Portugal, and businessmen who collaborated with the project, both Mexican and foreign, including Mexican magnate Carlos Slim. During the ceremony, concessions and memorandums of understanding were signed between the Mexican government and private investors,[60] as well as between the Mexican and Portuguese governments. José Rafael Ojeda Durán then proceeded to deliver a speech detailing the importance of the Corridor, a brief summary of its historical background, its goals and functionality. López Obrador lastly delivered a speech afterwards, further describing the Corridor's history since the 16th century, his satisfaction with the project, its collaboration with local communities and his expectations. After the ceremony, López Obrador and other attendees, including his son Gonzalo López Beltrán, the U.S. Ambassador to Mexico Ken Salazar, Carlos Slim and the governors of Oaxaca, Veracruz, Tabasco and Chiapas boarded the passenger train. They arrived at Coatzacoalcos after 8 hours, at 20:13.[61][62]
However, the passenger line is not the main feature of the Corridor, since its primary objective is the transportation of cargo from ocean to ocean through the Isthmus of Tehuantepec. The Corridor is not yet completely ready for this purpose, since various works needed at the port of Salina Cruz are still under construction. The delays on the construction of the jetties of the new port, in fact, impeded the inauguration of the Salina Cruz breakwater on the day of Line Z's opening.[63][64] On 26 February 2024, the inauguration of the Salina Cruz breakwater was held as announced by López Obrador on February 13. He promised, at the time of the announcement, that this project would "allow the arrival of enormous ships, the biggest kinds," referring to Post-Panamax ships, which are capable of carrying between 9,500 and 12,000 containers in one trip.[65][66] Experts and the authorities of the port, however, disagree with the President's statement: an experienced naval shipping agent stated that "by itself, the western breakwater does not offer an incentive for Post-Panamax ships to arrive at Salina Cruz." The port's authorities agree with this statement, but claim that the breakwater is the "first step" into being capable of receiving such ships. The second stage, starting after the inauguration, will consist on the construction of a container terminal with specialized cranes and freight train entrance areas, as well as one or two mooring docks, each being at least 300 metres (980 ft) long. The port's administration contemplates an investment of 14 billion pesos for the construction of these works, three times the amount that was invested on the breakwater.[63] During the breakwater's inauguration, López Obrador promised that the project would contribute to Mexico's economic partnership with the United States by enhancing commerce with the American East Coast.[67]

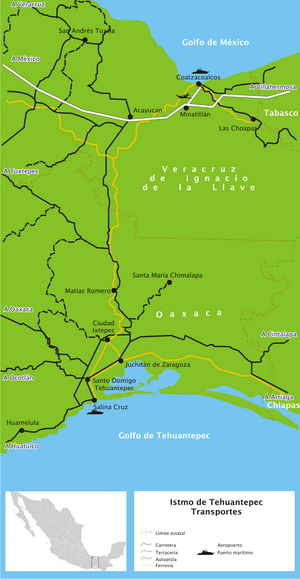

الرواق
According to the Institutional Program of the Interoceanic Corridor of the Isthmus of Tehuantepec, published by the Official Journal of the Federation on 3 July 2023, the area of the Isthmus of Tehuantepec is within 79 municipalities: 46 in Oaxaca and 33 in Veracruz, where a considerable portion of the population is Indigenous (57% self-identified and 30% Indigenous language speakers in the Oaxaca Isthmus, and 25% self-identified with 7% Indigenous language speakers in the Veracruz Isthmus). These municipalities were chosen for "their proximity to the Tehuantepec Isthmus Railway, cultural relevance, historical productive relations, their logistical relevance and productive potential to make the region competitive." According to the Program, 60% of the population of the Isthmus lives in poverty, and 15.5% live in extreme poverty.[68] In addition, in 2018, the six states with the highest poverty rates in Mexico were all in the South, including Veracruz and Oaxaca at spots 4 and 3 respectively, according to the CONEVAL. These poverty rates, in fact, worsened between 2008 and 2018, Veracruz's raising from 51.2% to 61.8% and Oaxaca's from 61.8% to 66.35%.[24] It is within this area where the infrastructure for Corridor will be built.
سكة حديد وموانئ برزخ تهوانتپك
Overview | |||||
---|---|---|---|---|---|
نوع الخدمة | Regional rail, freight rail | ||||
الحالة | Operational | ||||
المكان | Isthmus of Tehuantepec | ||||
الخدمة الأولى | September 2023 (freight)[59] 22 December 2023 (passenger)[31] | ||||
المشغلون الحاليون(s) | Ferrocarril del Istmo de Tehuantepec | ||||
Route | |||||
البداية | Coatzacoalcos | ||||
الوقفات | 10 | ||||
النهاية | Salina Cruz | ||||
المسافة المقطوعة | 308 kilometres (191 mi) | ||||
Technical | |||||
معدات السكك الحديدية | See Tren Interoceánico § Rolling stock | ||||
اتساع السكة | 4 ft 8 1⁄2 in (1٬435 mm) standard gauge | ||||
|
One of the most vital operations for the Corridor project is the rehabilitation of various portions of the Tehuantepec Isthmus Railway built under President Porfirio Díaz, so as to be adapted for the Corridor's current needs: 227 km (141 mi) of railway, 82 bridges and 290 drainage works were rehabilitated for Line Z; 310 km (190 mi), 91 bridges and 680 drainage works will be rehabilitated for Line FA, which reported a general progress of 40% in October 2023; 459 km (285 mi), 526 bridges and 318 drainage works will be rehabilitated for Line K, which had a reported general progress of 5.5% in October 2023.[69] As mentioned above, the rehabilitation is reportedly expected to result in a speed increase for trains using the railway, from 20 kilometres per hour (12 mph) to 70 km/h (43 mph) for cargo trains, and of up to 80 km/h (50 mph) for passenger trains, according to President López Obrador.[30][31]
The Railway will have three lines, the most essential being Line Z, of 212 km (132 mi) in length, which connects the port of Salina Cruz, Oaxaca, with the locality of es (Medias Aguas), Veracruz, thus allowing the port to connect with the port of Coatzacoalcos through the Ferrosur railways under the control of the Mexican government. Including these, Line Z reaches a length of 308 km (191 mi). Line K, 472 km (293 mi) long, will connect the cities of Ixtepec, Oaxaca, and Ciudad Hidalgo, Chiapas, reaching the Guatemala–Mexico border. Line FA is 328 km (204 mi) long and will connect the states of Veracruz, Chiapas and Tabasco, connecting with the es (Olmeca oil refinery) at the port of es (Dos Bocas, Tabasco), and, through Palenque, Chiapas, with the Maya Train, in the Yucatán Peninsula, two of the most prominent megaprojects of López Obrador's presidency.[69][70] In general, the Corridor will cover a distance of 303 km (188 mi) between the two ports.[23]
The Tehuantepec Isthmus Railway forms one of the many railroad projects López Obrador has executed throughout his presidency. Under his administration, a large number of railroad projects have been made which he intends to finish before the end of his term in September 2024, with the goal of returning passenger trains to Mexico, which haven't been used in decades as Mexico's current railroads are used only for cargo (with the exception of El Chepe), a fact which he views as "irresponsible" as passenger trains continue to be functional in Europe and Asia.[71]
As part of the project, a gas pipeline that crosses the Isthmus, between the two ports, and a liquefied natural gas plant in Salina Cruz will be built, so as to solve the issue of the lack of natural gas supply in the Mexican South and to be able to export gas to Asia, as former director Rafael Marín Mollinedo stated, who deems the supply of natural gas as necessary for Mexican industrial development. It will also supply the 10 industrial parks planned to be built for the project with natural gas. The company Temura Service & Consulting S.C., contracted by the Federal Electricity Commission, will be in charge of its construction, and will have a cost of 19 billion Mexican pesos. López Obrador stated that these projects will generate three thousand jobs in the South.[72][73] Another project in Salina Cruz is the creation of a delayed coking unit in the es (Antonio Dovalí Jaime oil refinery) (also known as the Salina Cruz refinery), in order to turn residual oil left from the oil refining process into useful fuel and petroleum coke.[74] Through this, it is projected to increase the refinery's daily gasoline production by 70 thousand barrels. It began construction in October 2022 and is projected to be inaugurated in October 2024, though its construction has undergone complications due to layoffs and delays due to funding issues. Reportedly, the government will invest 60 billion pesos on it.[75]
The ports of Coatzacoalcos and Salina Cruz will both be modernized and expanded: in Coatzacoalcos, a new highway access is being built, along a railway access by the port precinct of Laguna de Pajaritos, and customs is being modernized to operate with more agility. In Salina Cruz, a new port with an access depth of 24 m (79 ft), a 1,600 m (5,200 ft) long breakwater and a 300 m (980 ft) wide mouth to receive ships with large drafts are being built.[69] es (Raquel Buenrostro Sánchez), the Secretary of Economy, claimed that, due to the Corridor, the ports of Salina Cruz and Coaztacoalcos will become the largest ones in the country. As of May 2023, the largest ports in Mexico are Manzanillo, Colima, and Lázaro Cárdenas, Michoacán.[76]
In an interview, on 30 October 2023, Morales Ángeles stated that the government had invested "a little over 70 billion pesos" on the Corridor's infrastructure, including the rehabilitation of the three railway lines, the improvement of the ports of Coatzacoalcos, Salina Cruz, Port Chiapas and Dos Bocas, investments in highways and the rehabilitation of the Salina Cruz oil refinery.[77]
On 25 October 2023, the month following a meeting between President López Obrador and then Prime Minister of Portugal António Costa, the Mexican and Portuguese governments announced in the Global Gateway Forum held in Brussels, Belgium, their intention of creating a maritime corridor between the Mexican port of Coatzacoalcos and the Portuguese port of Sines. This corridor, according to the announcement, "will strengthen the production chains between both countries, as well as between North America and the European Union. As such, it will contribute to the exportation, storage and transshipment of energy," and it has the purpose of "bringing better security and predictability to international commerce."[78] According to the Bank of Mexico, the country registered a trade deficit of 467.2 million US dollars with Portugal throughout the first eight months of 2023, despite that the value of Mexican exports increased by 48.6% compared to the same period of the previous year.[79] On December 22, during Line Z's inauguration, the Portuguese Secretary of State for Foreign Business and Cooperation Francisco Gonçalo Nunes André, and Jennifer Feller, on behalf of the Mexican Secretary of Foreign Affairs, signed a memorandum of understanding to establish the maritime corridor. The corridor "is expected to profoundly impact relations between Latin America and Europe," according to a news report.[80][81]
المناطق الصناعية
As part of the Corridor project, 10 industrial parks will be built in the Isthmus area to encourage private investment. These parks will be installed in 10 areas referred to as Development Poles for Welfare (Polos de Desarrollo para el Bienestar, abbreviated as PODEBIS). Each of these parks will have a size of about 300 hectares (740 acres), and companies which choose to invest in them will be offered various tax benefits by the government: businesses that install a production plant in the Corridor will not pay an income tax for the first three years and will enjoy an income tax reduction of at least 50% and of up to 90% for the following three if they meet "certain job creation goals."[82] They also will not pay a value-added tax throughout the four years following 6 June 2023, the day following the publication of the decree encouraging investment through these tax benefits.[83] In addition to this, they will be guaranteed services of water, electricity and natural gas, as López Obrador declared on a press conference in May 2023.[84]
The industrial parks have interested businesses both national and international, such as vehicle manufacturers (though these have expressed their desire for better infrastructure in the region),[85] and various Taiwanese chip, semiconductor and electronic manufacturers.[86] It was reported on 19 June 2023 that Mexican and foreign businesses had presented, by then, 52 projects for the construction of plants that represent an investment of 4.5 billion US dollars.[87] In late July, es (Raquel Buenrostro Sánchez), the Secretary of Economy, estimated that the first five Development Poles which were declared will sum a private investment of 7 billion US dollars; she stated that the businesses which have contacted the Secretariat offer, on average, 1 billion dollars in investment.[88]
On 11 May 2023, the government reported the details of six of the ten Development Poles for Welfare, officially declaring them the following day. On October 11, three more Poles were declared, and on October 16 the tenth Pole was declared.[89][90][91][92]
- In Oaxaca:
- Salina Cruz, 82 ha (200 acres), 3 km (1.9 mi) from Line Z of the Tehuantepec Isthmus Railway, 8 km (5.0 mi) from the port, 36.8 km (22.9 mi) from Ixtepec Airport. (16°14′15″N 95°11′08″W / 16.23750°N 95.18556°W)
- San Blas Atempa, 331 ha (820 acres), 4.7 km (2.9 mi) from Line Z, 25 km (16 mi) from the port of Salina Cruz, 18.4 km (11.4 mi) from Ixtepec Airport. (16°21′03″N 95°10′57″W / 16.35083°N 95.18250°W) The ones declared on October 11 are:
- Santa María Mixtequilla, 502 ha (1,240 acres), next to the Mexican Federal Highway 185D and the 190D, 4.6 km (2.9 mi) from Line Z, 33 km (21 mi) from Ixtepec Airport. (16°25′06″N 95°14′25″W / 16.41833°N 95.24028°W)
- Ciudad Ixtepec, 412 ha (1,020 acres), next to the Mexican Federal Highway 185D, 3.5 km (2.2 mi) from Line Z, 33 km (21 mi) from Ixtepec Airport. (16°33′32″N 95°08′46″W / 16.55889°N 95.14611°W)
- Matías Romero Avendaño, 185 ha (460 acres), next to Line Z, near the Mexican Federal Highway 185 (the Transistmian Highway), 113 km (70 mi) from Ixtepec Airport. (17°12′58″N 95°03′02″W / 17.21611°N 95.05056°W) The one declared on October 16 is:
- Asunción Ixtaltepec, 246 ha (610 acres), located next to the Mexican Federal Highway 185, 1 km (0.62 mi) from Line Z, 47 km (29 mi) from Ixtepec Airport. (16°42′24″N 94°58′12″W / 16.70667°N 94.97000°W)
- In Veracruz:
- San Juan Evangelista, 360 ha (890 acres), 3.5 km (2.2 mi) from the railway node of es (Medias Aguas) which intersects the Tehuantepec Railway with railways heading to Central and Northern Mexico, 7.5 km (4.7 mi) from the Mexican Federal Highway 185. (17°43′12″N 95°00′52″W / 17.72000°N 95.01444°W)
- Texistepec, 462 ha (1,140 acres), 37 km (23 mi) from the port of Coatzacoalcos, 39.6 km (24.6 mi) from Minatitlán International Airport. (17°55′34″N 94°48′02″W / 17.92611°N 94.80056°W)
- Coatzacoalcos I, 257 ha (640 acres), 3.1 km (1.9 mi) from Line Z, 9 km (5.6 mi) from the port, 41.5 km (25.8 mi) from Minatitlán International Airport. (18°04′40″N 94°20′45″W / 18.07778°N 94.34583°W)
- Coatzacoalcos II, 131 ha (320 acres), 24.6 km (15.3 mi) from Minatitlán International Airport. (18°08′43″N 94°23′31″W / 18.14528°N 94.39194°W)
On June 20, the government published an invitation to tender to obtain a two-year long concession with possibility of purchase for five of the first six Poles (excluding San Blas Atempa). Registrations for the invitation were held between June 26 and 30,[93][94] and the decisions were officially made on November 17.[95][96] On October 30, the government published another invitation for the Poles declared throughout that month, and the decisions for it are programmed for 12 April 2024. The only Pole which has yet to be opened for bidding is San Blas Atempa.[97][98]
In the first weeks of October, the Secretary of Economy stated that over 100 businesses showed interest in the Corridor, and of these 12 reached the final phase of the bidding. By then, according to Enrique Nachón García, Secretary of Economic and Port Development (SEDECOP), these businesses were already enjoying the tax benefits offered at a state and federal level. Buenrostro added that there is contemplation for the construction of 2 industrial parks in the area of Tapachula, Chiapas, as the Corridor's Line K reaches Cuidad Hidalgo, at the south of the state.[95][99] On December 22, general director Morales Ángeles confirmed that there will be two additional Poles near Port Chiapas.[100]
On Wednesday November 22, the names of the companies which won the bidding of the first five Poles were revealed: Mota-Engil México S.A.P.I. de C.V., the Mexican subsidiary of the multinational construction group of Portuguese origin, won both of the Coatzacoalcos Poles and the Pole of Salina Cruz. This company was contracted in 2022 by the Secretariat of the Navy to rehabilitate 310 km (190 mi) of Line FA, and has also worked on the construction of several other railway works;[101] Grupo Constructor Urcedic S.A. de C.V., a Mexican construction company, won the Pole of San Juan Evangelista; and both Profharmax S.A. de C.V., a pharmaceutical and medical company, and Transportadora Comexsa S.A. de C.V., a Mexican industrial transportation company, won the Pole of Texistepec.[96] The concessions for these Poles were officially signed and offered during the Corridor's inauguration ceremony on 22 December 2023.[60] On December 14, a private organization named ProIstmo was presented, which seeks to "revive the South-Southeast of the country," contemplating an investment of 14 billion pesos in the Pole of Texistepec.[102] This organization is in charge of the development and construction of the Pole of Texistepec through the consortium between Profharmax and Transportadora Comexsa. Construction for the Pole of Texistepec officially started on 28 February 2024, with a planned investment of 1.8 billion pesos in urbanization.[103][104]
On 24 November 2023, López Obrador claimed on a morning press conference that a Danish fund, Copenhagen Infrastructure Partners (CIP), will invest 10 billion US dollars in the area of Ixtepec to produce green hydrogen, as one of the activities done during his administration to "avoid climate change," as he claimed in the announcement. A CIP spokesperson confirmed on August 18, two days after López Obrador revealed this project in a letter to US President Joe Biden (not mentioning the size of the investment at the time), "that we are involved in a large-scale green hydrogen project in the Oaxaca region in Mexico. [...] We will provide further updates as the project progresses." Though the president lamented that he would not see the project completed before the end of his term, he guaranteed that "this will help the Isthmus [of Tehuantepec] very, very much."[105][106][107][108] During the Corridor's inauguration ceremony, the Mexican government, represented by the Secretary of the Navy José Rafael Ojeda Durán, and CIP, represented by its partner Ole Kjems Sørensen, signed a memorandum of understanding to start the operations of Helax Istmo, the company responsible for this objective, originally created in 2022.[109]
ردود الأفعال والوقع الاقتصادي
According to Eduardo Romero Fong, coordinator for the development and strategy of the industrial productive sector and welfare of the Corridor, the Corridor has the potential to be a "cheaper and faster" alternative to the Panama Canal, as, as he stated, it will be capable of transporting "1.4 million containers annually from port to port in a journey of less than six hours." He also stated that by the year 2050 the Corridor will generate 1.6% of the national GDP, 50 billion US dollars of investment and 550 thousand jobs.[2] On 27 July 2023, the Mexican Secretary of Economy es (Raquel Buenrostro Sánchez) claimed the Corridor would contribute to 3% to 5% of the GDP once it starts operating at full capacity.[110] It also has an advantage over the Panama Canal regarding its location, as American businesses seeking to transport cargo from one ocean to the other wouldn't have to travel all the way south to Panama, resulting in much faster transportation.[39]
Alfredo Oranges, ambassador of Panama in Mexico, stated in May 2023 that, rather than a competitor to the Panama Canal, the Corridor can actually be "complementary" to it, offering to the government of López Obrador the century-old experience in port infrastructure of Panama and the capacity to receive cargo ships with large drafts.[111] The former general director of the CIIT Rafael Marín Mollinedo agrees with this idea, since the Panama Canal "is saturated and cannot cope with all the demand," thus he states that "we don't call it an alternative, we prefer to refer to it as a complement."[23]
Economists have observed that, if done well, the Corridor has a strong opportunity to boost the Mexican economy, especially in the South, by facilitating trade between the American East Coast and the Mexican South, as Mexican exports in this region are "very underrepresented," as Mexican economists Luis de la Calle and Adrián de la Garza pointed out. López Obrador has also expressed his expectation for the Corridor to improve trade with Asia, especially with China.[112] From these factors, they agree that it has the potential to become the most important infrastructure project of López Obrador's presidency. Economist and analyst of the energy sector Rosanety Barrios suggests that, through government investments in highways, ports, railways, and offering safety and energy services, the Mexican South can gradually achieve obtaining the conditions of the North, a region which has enjoyed economic growth for years.[21] Analysts have also concluded that the project will benefit various impoverished communities of Oaxaca by offering employment and access to services like health, water, sewer systems and education, along with various other improvements in infrastructure.[113] Even some of López Obrador's critics, like economist and researcher Jorge Basave Kunhardt, have recognized the potential of the project, deeming it as "a promising project, in my opinion the only one with long-term sustainable projection among the megaprojects executed in this sexenio," though he noted that it "is not a project with short-term results, and it will only be successful if it transcends sexenios and administrations from various parties."[22]
In September 2023, it was reported that the South and Southeast of Mexico, as a result of the various megaprojects López Obrador's administration has developed in the region, including the Corridor, has experienced unprecedented levels of economic growth after facing decades of stagnation. The reports found that the Mexican GDP on a nation-wide scale grew to an annual rate of 3.6% during the second quarter of the year, and that the eight states of the South and Southeast grew by 6%, twice the amount of the northern states.[114][115]
The Mexican Secretary of Navy José Rafael Ojeda Durán stated on 1 June 2023, during a conference in Ciudad Madero, Tamaulipas, during the National Navy Day, that with the Corridor Mexico will become "a world shipping power" in the near future.[116] Former Secretary of Government Adán Augusto López stated in a speech at Coatzacoalcos, prior to the 2024 Mexican general election, that the Corridor will not only be beneficial to Mexico, but to the rest of the world: "the Transisthmian [Corridor] is an old dream of the Mexicans and it's now a reality for all the inhabitants, from Salina Cruz to Coatzacoalcos; it's not just about connecting the country, it's about connecting the world."[117]
تحديات
Though many view the creation of the Corridor in a positive way, analysts have pointed out that in order for the Corridor to achieve its goals it will have to overcome some considerable challenges, especially regarding safety and infrastructure, as crime and lack of proper infrastructure in the Mexican South have been a persistent issue.[39]
In terms of infrastructure, the Corridor has the challenge of supplying the necessary amounts of natural gas, as it is estimated that it would require a supply of 11.3 billion cubic feet (320,000,000 m3) of natural gas, which would mean an increase of over 120% in the national distribution of hydrocarbon. At least 20 billion cu ft (570,000,000 m3) of natural gas, above the 9 billion cu ft (250,000,000 m3) which are currently supplied (as of August 2023), will have to be supplied daily for the desired industrial activities to be carried out. This imposes a challenge since the majority of Mexico's current natural gas supply is imported, especially from the United States, and since the state-owned company Pemex has faced complications in its attempts to increase the country's gas production.[118] The es (Mexican Institute for Competitiveness) (IMCO, by its initials in Spanish) has reported that a larger supply of natural gas will be needed for Mexico to take advantage of the recent impact which the economic phenomenon known as nearshoring has had in the country, as, despite the country's gas pipeline network's length having increased by over 50% between 2011 and 2022, it is still insufficient for the supply for the Mexican South and Southeast, where the Corridor is being built, a factor which has contributed to that region's lack of industrial development and economic competitiveness. As of 2023, nearly half of the demand for natural gas was concentrated in the six states bordering the United States, while only 16% was concentrated in the South and Southeast.[119]
es (Francisco N. González Díaz), president of the National Industry of Auto Parts (Industria Nacional de Autopartes), has stated that, though various national vehicle manufacturers have shown interest in the Corridor, not all of them could be functional in the region due to its highway infrastructure.[85] Carlos Corral Serrano, executive director of the Mexican Association of Urban Planners (Asociación Mexicana de Urbanistas), has found the existing infrastructure of the region insufficient and in need of improvement. A limited amount of qualified personnel in the region could also be a challenge, which thus makes an investment in education and training a priority for the Corridor.[120]
Another potential challenge the Corridor faces is the demand for an alternative route to the Panama Canal. The Mexican government has shown great enthusiasm for the project, as the Canal has suffered an intense drought which has reduced the number of ships that can cross it per day and has limited the weight each ship can carry, an issue which Mexico sees as an opportunity since such issues caused by climate change may increase the demand for a land-based alternative route, in addition to the fact that Mexico became a highly attractive country for investors in recent times.[121] However, former director of the Regulatory Agency of Railway Transportation in Mexico (Agencia Reguladora de Transporte Ferroviario en México), Benjamín Alemán, believes that the current infrastructure of the Corridor is not sufficient to attract ships with large drafts, thus it is probable that only smaller ships would be interested in using it, though the Corridor's closer proximity to Asia and the American East Coast, one of the busiest trade routes which cross through the Americas, could be a point in its favor.[122]
Independently from these factors, the British newspaper Financial Times reported on 16 October 2023 that international shipping companies and other such entities have yet to show significant interest for the Corridor; an executive at Unique Logistics, for example, stated that whenever an alternative trade route is available, importers become highly skeptical and unsure of whether they should use it or not due to their lack of knowledge on its reliability. Lars Østergaard Nielsen, an executive at A.P. Møller-Mærsk (one of the world's largest container shipping groups), stated that the Corridor "could be very useful" if more manufacturing came to the Mexican South, but otherwise there would be "less demand." In addition to this factor, the report also found that the Corridor's initial phase will have the capicity to transport a maximum of 1.14 million twenty-foot equivalent units (TEUs) annually, and in September a projection was presented which indicated that 304 thousand would move through it by 2028 and 1.3 million by 2036, which is considerably less than the amount transported through the Panama Canal, which transported 10.9 million in 2022. The report states that the construction of sufficient infrastructure for the project could take years and large sums of money, which makes it a risky venture.[121]
جدالات
Indigenous and environmental activism
Though some observers have pointed out that the Corridor has the potential to boost the economy of Southern Mexico and benefit the local population and impoverished communities of Oaxaca, as is one of the goals of the project,[113] several incidents have occurred in which Indigenous and environmental activists have clashed with the interests of the government for the Corridor or have faced other related problems.
Several Indigenous communities in Oaxaca, for instance, have raised their concern regarding the environmental impact of the Corridor, with communities like that of the locality of Puente Madera, in the Zapotec municipality of San Blas Atempa, protesting against the construction of an industrial park in the land over this issue,[123] despite the government's payment of 52 million pesos for it. Later, in June 2023, a federal court in Salina Cruz ruled in favor of the community after reporting irregularities in the purchase of the land, temporarily suspending the construction of the park.[124] Prior to this, on April 28, a violent incident occurred in the site of Mogoñé Viejo, in San Juan Guichicovi, when Mixe activists clashed with the authorities after two months of blocking the Corridor's workers from rehabilitating a portion of the Transisthmian Railway. The clash resulted in the arrest of six protesters, two men and four women, one of whom was beaten by the authorities, according to eyewitnesses. The Secretariat of the Navy claimed this happened in response to a group of protesters attacking the Corridor's workers verbally and physically using poles and machetes. Nonetheless, organizations such as the EZLN and the National Indigenous Congress would refer to this event as an act of political repression, and demanded for the protesters to be liberated immediately.[125] They were all liberated two days later.[126]
Such conflicts with Indigenous environmental activists were already expected, as various Indigenous communities of the Isthmus region are heavily opposed to the exploitation of their lands' resources by industrial parks, having entered into conflicts for them for decades. This, the UNAM academic Antionio Suárez suggests, could be one of the Corridor's greatest challenges, though he stated that, regardless, the Corridor is still "more positive than negative for the nation."[23] The Indigenous peoples desire, above all other services, better agricultural infrastructure which does not negatively interfere with the local biodiversity and their traditions, in addition to the depollution of the land and water, hence the environmental concerns due to the industrial parks.[118] Furthermore, the Isthmian population is concerned regarding a perceived surge in crime and violence which was not present prior to the project's creation, as locals claim that the Isthmus region was peaceful, but as the project progressed "unprecedented" acts of violence started to take place. This has also made Indigenous communities afraid of losing their identity. There have also been concerns over several activists, including elderly people, being criminally charged, allegedly over their opposition to the project.[127]
On 4 July 2023, a Zapotec activist from Santa María Mixtequilla, Noel López Gallegos, was found dead by the local police in the municipality 24 hours after being reported as missing. The cause of his death was apparently an inflicted head injury. Prior to his death, López Gallegos and his brother had questioned the payment of 130 million pesos which the community received in exchange for the land, both of them claiming that it should be distributed among all four thousand inhabitants of the municipality, to the discomfort of the local comuneros since, as he claimed, the payment only benefited them and their offspring. His death sparked outrage, with the Union of Communities of the Northern Zone of the Isthmus of Tehuantepec (Ucizoni) condemning the murder and blaming it as a result of "how the imposition of a megaproject breaks the community fabric" since he was a member of a peaceful civil resistance group which questioned the development of the Corridor.[128] As of July 12, little information is known regarding this case, other than that the police arrested a man in relation to his disappearance two days after the body was found. Acts of violence like such have worried various Indigenous communities in the Isthmus.[129]
In late July, 23 civil society organizations registered, after three days of investigation, various violations to human rights in the Isthmus region related to the construction of the Corridor, such as intimidation from members of the Mexican National Guard, in Santa María Mixtequilla, to members of the Community Assembly and people who showed resistance to the project, illegal occupation of lands, dispossessions and acts of physical aggression against comuneros and comuneras in the town of Santa Cruz Tagolaba, in Tehuantepec, among other violations in other sites committed by the National Guard, the Armed Forces, the state police and other authorities, businesses and armed groups.[130] The organizations reported at least 21 cases of intimidation and threats against community defenders or their families, 11 acts of physical and psychological violence, three homicides between October 2022 and July 2023, and other cases of human rights being violated in various parts of the Isthmus.[131] Additionally, farmers and local community members have reported how their property and land has been stolen, that they've been victims of extortion and that violence has increased in the Isthmus of Tehuantepec since the project became known, yet the authorities have done little to combat this issue: "It's already been two years and the Attorney General of the Republic, the Vice-Attorney of the Isthmus and the Attorney General of the State have done nothing, the situation is still the same. [...] These people [the alleged criminals] [...] are walking freely like any other citizen," a local comunero told reporters in October 2023.[132] Likewise, local communities have also claimed that the Corridor authorities have not fulfilled many of their promises. Some inhabitants of the municipality of Salina Cruz, for example, claim that during the works of the railway's rehabilitation some people were evicted, though new homes for them are being built, and promises to improve services of electricity and water have remained unfulfilled, just weeks before the Corridor's planned inauguration: "They [the Corridor authorities] used to beg us and offer us about everything, now they won't even acknowledge us," they claim.[133]
In general, reactions of Indigenous peoples and Isthmian communities to the project have been polarized: on one hand are the people who rejoice over the expected increase in investment, tourism and economic growth, as well as the expected improvements in infrastructure and services; these people believe this project is one of the greatest that have been executed in the region in decades. On the other hand are the people concerned and upset over the issues mentioned above, as concerns over allegedly flawed environmental studies, the perceived rise of organized crime, forced relocations of Indigenous communities and other mentioned issues persist.[134]
المدراء
- Rafael Marín Mollinedo, businessman from Quintana Roo, former director of Urban Services of the Federal District from 2000 to 2005 (24 June 2019 – 26 November 2022).[135][29][136]
- Raymundo Morales Ángeles, vice admiral of the Mexican Navy and naval engineer (29 November 2022 – currently in charge).[38]
ملاحظات
المراجع
- ^ "What is the Interoceanic Corridor of the Isthmus of Tehuantepec (CIIT)?". Opportimes. 19 November 2021. Retrieved 7 July 2023.
- ^ أ ب "Interoceanic Corridor in Mexico will move 1.4 million containers a year". Mexico Daily Post. 10 November 2022. Retrieved 7 July 2023.
- ^ أ ب ت Hovey, Edmund Ovis (1907). "The Isthmus of Tehuantepec and the Tehuantepec National Railway". Bulletin of the American Geographical Society. 39 (39): 78–91. doi:10.2307/198380. JSTOR 198380. Retrieved 9 July 2023.
- ^ أ ب ت ث Reina, Leticia (2019). "El ferrocarril de Tehuantepec. Un sueño para conectar los dos océanos, siglo XIX". Alquimia (in الإسبانية) (65): 6–27. Retrieved 8 July 2023.
- ^ أ ب ت ث ج ح Blázquez Domínguez, Carmen (1992). "Proyectos de comunicación por el istmo de Tehuantepec 1842-1860". La Palabra y el Hombre (in الإسبانية). Universidad Veracruzana (83): 199–217. Retrieved 8 July 2023.
- ^ أ ب Humboldt, Alexander von (1811). Political Essay on the Kingdom of New Spain. Vol. 1. Translated by Black, John. New York: I. Riley. pp. 9, 13–29. Retrieved 23 October 2023.
- ^ Humboldt, Alexander von (1811). Political Essay on the Kingdom of New Spain. Vol. 2. Translated by Black, John. New York: I. Riley. pp. 153—158. Retrieved 23 October 2023.
- ^ Gordon 2013, p. 6.
- ^ أ ب ت Román, Julia (1933). "Historia de los ferrocarriles de México". Anales del Museo Nacional de Arqueología, Historia y Etnografía (in الإسبانية). 25 (VIII): 389–396. Retrieved 27 November 2023.
- ^ An account of the isthmus of Tehuantepec in the Republic of Mexico: with proposals for establishing a communication between the Atlantic and Pacific oceans. London: J. D. Smith and Co. 1846. pp. 10, 85–91. Retrieved 2 December 2023.
- ^ أ ب Rippy, J. Fred (1920). "Diplomacy of the United States and Mexico regarding the Isthmus of Tehuantepec, 1848‑1860". Mississippi Valley Historical Review. 6 (4): 503–531. Retrieved 21 March 2024.
- ^ Gordon 2013, pp. 7—8.
- ^ "Manning and MacKintosh Papers". Latin American Network Information Center. University of Texas. Archived from the original on 9 July 2023. Retrieved 9 July 2023.
- ^ Suárez, Ana R. (2001). ""The Precious, the Priceless Right of Way across the Isthmus of Tehuantepec" (1846-1849)". The Journal of Popular Culture. 35 (2): 153–160. doi:10.1111/J.0022-3840.2001.00153.X. ISSN 1540-5931.
- ^ أ ب Gordon 2013, pp. 11—19.
- ^ أ ب Williams, John Jay (1852). The Isthmus of Tehuantepec: being the results of a survey for a railroad to connect the Atlantic and Pacific oceans, made by the scientific commission under the direction of Major J.G. Barnard. New York: D. Appleton & Company. pp. 11, 112–121. Retrieved 29 November 2023.
- ^ Gordon 2013, pp. 12—13, 23—25.
- ^ Gordon 2013, pp. 27—30.
- ^ أ ب LaFranchi, Howard (4 September 1996). "Mexico Wants Its Own 'Panama Canal' - Without US". The Christian Science Monitor. Retrieved 7 July 2023.
- ^ "La historia del tren en México". México Desconocido (in الإسبانية). 27 August 2010. Retrieved 27 November 2023.
- ^ أ ب "Las oportunidades del Corredor Interoceánico del Istmo de Tehuantepec". México, ¿cómo vamos? (in الإسبانية). 29 June 2023. Retrieved 7 July 2023.
- ^ أ ب ت Basave Kunhardt, Jorge (13 July 2023). "El Corredor Interoceánico del Istmo de Tehuantepec". Animal Político (in الإسبانية). Retrieved 31 July 2023.
- ^ أ ب ت ث Guzmán, Nicolás (23 November 2022). "El histórico corredor interoceánico que revivió AMLO". DW Español (in الإسبانية). Retrieved 9 July 2023.
- ^ أ ب ت Duhalt, Adrian (12 June 2021). "The Interoceanic Corridor of Mexico's Isthmus of Tehuantepec and the North-South Development Gap". Rice University’s Baker Institute for Public Policy. doi:10.25613/q43f-4m71. Retrieved 31 July 2023.
- ^ "Antecedentes e Inicio de Operaciones del Ferrocarril del Istmo de Tehuantepec, S.A. de C.V." Ferrocarril del Istmo de Tehuantepec (in الإسبانية). Archived from the original on 16 July 2023. Retrieved 15 July 2023.
- ^ "Presentación del Programa para el Desarrollo del Istmo de Tehuantepec". Corredor Interoceánico- Istmo de Tehuantepec (in الإسبانية). 23 December 2018. Retrieved 10 July 2023.
- ^ "Comunicado No. 001 El Corredor Interoceánico del Istmo de Tehuantepec firma Convenios de Colaboración". Corredor Interoceánico- Istmo de Tehuantepec (in الإسبانية). gob.mx. 17 September 2019. Retrieved 7 July 2023.
- ^ "DECRETO por el que se crea el organismo público descentralizado, con personalidad jurídica y patrimonio propio, no sectorizado, denominado Corredor Interoceánico del Istmo de Tehuantepec". Diario Oficial de la Federación (in الإسبانية). Mexico City. 14 June 2019. Retrieved 9 July 2023.
- ^ أ ب "Designa AMLO a Marín Mollinedo en Istmo, controlará paso de migrantes". Almomento.mx (in الإسبانية). 24 June 2019. Retrieved 9 July 2023.
- ^ أ ب Pérez, Maritza (8 June 2020). "Inician obras de rehabilitación del Ferrocarril del Istmo de Tehuantepec". El Economista (in الإسبانية). Retrieved 8 July 2023.
- ^ أ ب ت ث ""El 22 de diciembre se inaugura el Tren del Istmo": AMLO". Proceso (in الإسبانية). 14 October 2023. Retrieved 15 October 2023.
- ^ أ ب Silva Alanis, Pedro (2 September 2023). "Tren interoceánico, al 90%; muelle de Salina Cruz, al 30%". El Imparcial de Oaxaca (in الإسبانية). Retrieved 4 September 2023.
- ^ Ferrocarril del Istmo de Tehuantepec, S.A. de C.V. (14 February 2022). "Avances al 14 de febrero de 2022. Actualmente existen 12 frentes de trabajo realizando las labores de rehabilitación a lo largo de toda la Línea Z, con estas acciones aseguramos un avance permanente en toda la obra. El Ferrocarril del Istmo de Tehuantepec, S.A. de C.V.es una realidad y traerá innumerables beneficios a todo México. 🚂🇲🇽". Facebook (in الإسبانية). Retrieved 4 September 2023.
- ^ Martínez, Fluvio Cesar (20 July 2023). "Inician construcción de estación del Ferrocarril del Istmo de Tehuantepec en Coatzacoalcos". Milenio (in الإسبانية). Retrieved 15 October 2023.
- ^ Matías, Pedro (20 July 2023). "Inconformes denuncian tala de 200 árboles para construir andenes del ferrocarril en Salina Cruz". Proceso (in الإسبانية). Retrieved 4 September 2023.
- ^ González, Paty (26 July 2023). "No se talará guanacastle de 150 años en Salina Cruz". Meganoticias (in الإسبانية). Retrieved 4 September 2023.
- ^ González, Paty (8 August 2023). "Comienzan con tala de árboles para despejar vías del ferrocarril". Meganoticias (in الإسبانية). Retrieved 5 September 2023.
- ^ أ ب Del Toro, Evangelina (29 November 2022). "Marín Mollinedo sería titular de la ANAM; al CIIT Valmte. Raymundo Morales". T21 (in الإسبانية). Retrieved 9 July 2023.
- ^ أ ب ت Toletino Morales, Juan (30 May 2023). "Ferrocarril del Istmo: a un siglo, ¿qué puede (volver a) salir mal?". Expansión (in الإسبانية). Retrieved 8 July 2023.
- ^ Montesinos, Carlos (24 May 2023). "AMLO niega acuerdo por 7 mil mdp con Germán Larrea, pero confirma negociaciones por Ferrosur". Reporte Índigo (in الإسبانية). Retrieved 10 July 2023.
- ^ De la Rosa, Alejandro (2 June 2023). "Gobierno extenderá concesión de Ferrosur a cambio de tramos ferroviarios". El Economista (in الإسبانية). Retrieved 10 July 2023.
- ^ Carrillo, Emmanuel (31 May 2023). "Grupo México y Gobierno llegan a acuerdo sobre ocupación de vías de Ferrosur". Forbes México (in الإسبانية). Retrieved 10 July 2023.
- ^ "Corredor interoceánico presenta avance del 79%, reporta Marina". El Universal (in الإسبانية). 21 March 2023. Retrieved 15 July 2023.
- ^ Gutiérrez, Noemí (28 May 2023). "AMLO confirma inauguración del Tren del Corredor Interoceánico para septiembre". El Heraldo de México (in الإسبانية). Retrieved 7 July 2023.
- ^ "Proyecta gobierno federal inaugurar en diciembre todas las obras del Corredor Interoceánico en Oaxaca". El Universal Oaxaca (in الإسبانية). 26 June 2023. Retrieved 9 July 2023.
- ^ "AMLO presentó la primera locomotora del Tren Interoceánico". Infobae (in الإسبانية). 13 August 2023. Retrieved 30 August 2023.
- ^ Ruiz, Laura (27 August 2023). "Tren Turístico Puebla-Cholula llega a su nueva casa en Veracruz". El Universal Puebla (in الإسبانية). Retrieved 30 August 2023.
- ^ Escobar, Julio (26 August 2023). "Llegó a Coatzacoalcos el tren turístico que formará parte del Corredor Interoceánico". Diario del Istmo (in الإسبانية). Retrieved 31 August 2023.
- ^ Malpica, Fernanda (21 August 2023). "Corredor Interoceánico: A partir de esta fecha habrá tren de pasajeros Oaxaca-Veracruz". La Silla Rota Veracruz (in الإسبانية). Retrieved 30 August 2023.
- ^ Carmona, Sergio (30 August 2023). "Tren Interoceánico se mueve, tuvo sus primeras pruebas con carga". Vanguardia MX (in الإسبانية). Retrieved 31 August 2023.
- ^ "Tren Transístmico Realiza Primer Recorrido de Prueba de Veracruz a Oaxaca". N+ (in الإسبانية). 30 August 2023. Retrieved 31 August 2023.
- ^ Morales, Alberto; Villa y Caña, Pedro (29 August 2023). "AMLO presume aplausos por primeras pruebas del tren del Corredor Interoceánico del Istmo de Tehuantepec". El Universal (in الإسبانية). Retrieved 31 August 2023.
- ^ Briseño, Patricia (10 September 2023). "Tren de pasajeros Interoceánico arranca pruebas". Excélsior (in الإسبانية). Retrieved 2 October 2023.
- ^ Antonio Sotelo, Osvaldo (11 September 2023). "¿Cuánto duró el primer recorrido de prueba del Tren Interoceánico de Coatzacoalcos a Salina Cruz?". Diario del Istmo (in الإسبانية). Retrieved 2 October 2023.
- ^ "Difunde AMLO video de recorrido de prueba del Tren Interoceánico". La Jornada (in الإسبانية). 17 September 2023. Retrieved 2 October 2023.
- ^ "AMLO completes first interoceanic passenger train trip". Mexico News Daily. 18 September 2023. Retrieved 2 October 2023.
- ^ Chiñas, Sayda (17 September 2023). "Reciben en Veracruz al Presidente tras recorrido en Tren Interocéanico". La Jornada (in الإسبانية). Retrieved 2 October 2023.
- ^ Dina, Eduardo; Villa y Caña, Pedro (18 September 2023). "Tren Interoceánico para pasajeros, en diciembre; para carga, "a partir de este momento": Marina". El Universal (in الإسبانية). Retrieved 2 October 2023.
- ^ أ ب Villa Román, Elisa (1 October 2023). "Tren Interoceánico del Istmo de Tehuantepec: ruta completa, estaciones y fechas de inauguración". El País (in الإسبانية). Retrieved 2 October 2023.
- ^ أ ب López Cabrera, Heder (22 December 2023). "Firmadas concesiones para Polos del Corredor Interoceánico, confirma alcalde de Coatzacoalcos". Diario del Istmo (in الإسبانية). Retrieved 22 December 2023.
- ^ Varela, Micaela (22 December 2023). "López Obrador echa a andar el tren Interoceánico que unirá el golfo de México con el Pacífico". El País (in الإسبانية). Retrieved 22 December 2023.
- ^ Villa y Caña, Pedro (22 December 2023). "Tras 8 horas, llega AMLO a Coatzacoalcos, Veracruz, en tren interoceánico". El Universal (in الإسبانية). Retrieved 22 December 2023.
- ^ أ ب López Morales, Alberto (26 February 2024). "Rompeolas de Salina Cruz, primer paso: faltan 14 mil mdp para que lleguen enormes buques que promete AMLO". El Universal Oaxaca (in الإسبانية). Retrieved 3 March 2024.
- ^ "Aún no hay fecha para inicio de tránsito de mercancías por el CIIT". La Jornada Veracruz (in الإسبانية). 22 December 2023. Retrieved 23 December 2023.
- ^ Morales, Alberto; Villa y Caña, Pedro (13 February 2024). "AMLO alista inauguración de rompeolas en el Puerto de Salina Cruz". El Universal (in الإسبانية). Retrieved 13 February 2024.
- ^ Sabanero, Axel (13 February 2024). "Tren del Istmo: estos son los buques masivos que llegarán al puerto de Salina Cruz". Radio Fórmula (in الإسبانية). Retrieved 13 February 2024.
- ^ Gutiérrez, Julio (27 February 2024). "Rompeolas de Salina Cruz, nueva puerta comercial". La Jornada (in الإسبانية). Retrieved 3 March 2024.
- ^ "PROGRAMA Institucional del Corredor Interoceánico del Istmo de Tehuantepec 2023-2024". Diario Oficial de la Federación (in الإسبانية). Mexico City. 3 July 2023. Retrieved 11 July 2023.
- ^ أ ب ت Pamplona, Fabian (17 October 2023). "Corredor Interoceánico: Semar informa sobre avances en puertos de Coatzacoalcos, Salina Cruz, Chiapas y Dos Bocas". Diario del Istmo (in الإسبانية). Retrieved 23 October 2023.
- ^ "3 LINEAS FERROVIARIAS ADMINISTRADAS POR EL FIT". Ferrocarril del Istmo de Tehuantepec (in الإسبانية). Archived from the original on 9 July 2023. Retrieved 8 July 2023.
- ^ Guillén, Beatriz (22 July 2023). "El legado del sexenio: vuelven los trenes a México". El País (in الإسبانية). Retrieved 9 August 2023.
- ^ Hernández, Leticia (30 June 2022). "Así será el gasoducto que atravesará el Istmo de Tehuantepec". El Financiero (in الإسبانية). Retrieved 10 July 2023.
- ^ Martínez, Everardo (28 June 2022). "Gasoducto del Istmo de Tehuantepec va a costar 19 mmdp". El Heraldo de México (in الإسبانية). Retrieved 10 July 2023.
- ^ "Pemex construirá planta coquizadora en Oaxaca, pero ¿qué es y para qué sirve?". El Financiero (in الإسبانية). 1 July 2022. Retrieved 10 December 2023.
- ^ López Morales, Alberto (5 December 2023). "Con cortes de energía y telefonía, trasladan estructuras para coquizadora de Salina Cruz en Oaxaca". El Universal Oaxaca (in الإسبانية). Retrieved 9 December 2023.
- ^ Morales, Roberto (15 May 2023). "Salina Cruz y Coatzacoalcos serán los puertos más grandes: SE". El Economista (in الإسبانية). Retrieved 9 July 2023.
- ^ Morales Ángeles, Raymundo (30 October 2023). "Poco más de 70 mmdp se han invertido en el Corredor Interoceánico del Istmo de Tehuantepec, revela Vicealmirante". Enfoque Noticias (Interview) (in الإسبانية). Interviewed by Alicia Salgado. Retrieved 9 December 2023.
- ^ Dina, Eduardo (26 October 2023). "México y Portugal anuncian corredor marítimo Coatzacoalcos-Sines". El Universal (in الإسبانية). Retrieved 25 November 2023.
- ^ Pamplona, Fabian (30 October 2023). "Corredor marítimo de Coatzacoalcos - Portugal, cuales son las ventajas que ofrece este proyecto". Diario del Istmo (in الإسبانية). Retrieved 25 November 2023.
- ^ Golden, Ivan (24 December 2023). "Coatzacoalcos-Sines Corridor Boosts Mexico-Portugal Trade". THX News. Retrieved 24 December 2023.
- ^ "México y Portugal firman Memorándum de Entendimiento para el establecimiento del corredor marítimo Coatzacoalcos-Sines". Secretariat of Foreign Affairs (Mexico) (in الإسبانية). 22 December 2023. Retrieved 24 December 2023.
- ^ Bocanegra, Romina (26 June 2023). "Asignarían los 10 parques industriales del CIIT en diciembre". Real State Market (in الإسبانية). Retrieved 9 July 2023.
- ^ Gordillo, Agustín (9 June 2023). "Estos son estímulos de IVA e ISR para invertir en el Istmo de Tehuantepec". El Contribuyente (in الإسبانية). Retrieved 20 July 2023.
- ^ "Gobierno de México prepara licitaciones de 10 parques industriales en el Istmo de Tehuantepec". Capital 21 (in الإسبانية). 30 May 2023. Retrieved 7 July 2023.
- ^ Hernández, Enrique (20 June 2023). "Fabricantes taiwaneses de chips se apuntan a invertir en el Corredor Interoceánico". Forbes México (in الإسبانية). Retrieved 8 July 2023.
- ^ Hernández, Enrique (19 June 2023). "Corredor Interoceánico suma cartas de intención para inversiones por 4 mil 500 mdd". Forbes México (in الإسبانية). Retrieved 7 July 2023.
- ^ Morales, Roberto (26 July 2023). "La SE estima captar 7,000 millones de dólares en 5 polos de desarrollo del Corredor Interocéanico". El Economista (in الإسبانية). Retrieved 13 October 2023.
- ^ "Estos son los polos de desarrollo del Corredor Interoceánico del Istmo de Tehuantepec y su conectividad logística". T21 (in الإسبانية). 11 May 2023. Retrieved 11 July 2023.
- ^ "Gobierno de México lanzará licitaciones para otros tres polos de desarrollo en el Corredor Transístmico". EL CEO (in الإسبانية). 11 October 2023. Retrieved 13 October 2023.
- ^ Antonio Sotelo, Osvaldo (16 October 2023). "Publican declaratoria de otro polo de desarrollo del Corredor Interoceánico". Diario del Istmo (in الإسبانية). Retrieved 24 November 2023.
- ^ Further details and maps of each of these Development Poles may be found in the following publications of the Official Journal of the Federation, from 12 May 2023:
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar Salina Cruz". Diario Oficial de la Federación (in الإسبانية). Mexico City. 12 May 2023. Retrieved 11 July 2023.
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar San Blas Atempa". Diario Oficial de la Federación (in الإسبانية). Mexico City. 12 May 2023. Retrieved 11 July 2023.
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar San Juan Evangelista". Diario Oficial de la Federación (in الإسبانية). Mexico City. 12 May 2023. Retrieved 11 July 2023.
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar Texistepec". Diario Oficial de la Federación (in الإسبانية). Mexico City. 12 May 2023. Retrieved 11 July 2023.
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar Coatzacoalcos I." Diario Oficial de la Federación (in الإسبانية). Mexico City. 12 May 2023. Retrieved 11 July 2023.
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar Coatzacoalcos II". Diario Oficial de la Federación (in الإسبانية). Mexico City. 12 May 2023. Retrieved 11 July 2023.
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar Santa María Mixtequilla". Diario Oficial de la Federación (in الإسبانية). Mexico City. 11 October 2023. Retrieved 13 October 2023.
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar Ciudad Ixtepec". Diario Oficial de la Federación (in الإسبانية). Mexico City. 11 October 2023. Retrieved 13 October 2023.
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar Matías Romero Avendaño". Diario Oficial de la Federación (in الإسبانية). Mexico City. 11 October 2023. Retrieved 13 October 2023.
- "ACUERDO por el que se emite la Declaratoria del Polo de Desarrollo para el Bienestar Asunción Ixtaltepec". Diario Oficial de la Federación (in الإسبانية). Mexico City. 16 October 2023. Retrieved 24 November 2023.
- ^ "México lanza licitación para 5 polos de desarrollo del Corredor Interoceánico". Expansión (in الإسبانية). 20 June 2023. Retrieved 12 July 2023.
- ^ "Gobierno de AMLO lanza la convocatoria a licitación para 5 de los 10 polos de desarrollo en el Istmo". EL CEO (in الإسبانية). 20 June 2023. Retrieved 12 July 2023.
- ^ أ ب Gutiérrez Pacheco, Laura (12 October 2023). "Corredor Interoceánico: revelan cuantas empresas están en fase final de licitación de los Polos de Desarrollo". Diario del Istmo (in الإسبانية). Retrieved 13 October 2023.
- ^ أ ب Antonio Sotelo, Osvaldo (22 November 2023). "Corredor Interoceánico: estas empresas ganaron las primeras licitaciones". Diario del Istmo (in الإسبانية). Retrieved 24 November 2023.
- ^ Del Toro, Evangelina (31 October 2023). "CIIT LANZA CONVOCATORIAS PARA CUATRO POLOS DE DESARROLLO". T21 (in الإسبانية). Retrieved 24 November 2023.
- ^
- "Corredor Interoceánico del Istmo de Tehuantepec: CONVOCATORIA A LA LICITACIÓN PÚBLICA INTERNACIONAL NÚMERO LPIBI-013AYH-PODEBI-6-2023 PARA EL ESTABLECIMIENTO DEL "POLO DE DESARROLLO PARA EL BIENESTAR ASUNCIÓN IXTALTEPEC" EN EL ISTMO DE TEHUANTEPEC". Diario Oficial de la Federación (in الإسبانية). Mexico City. 30 October 2023. Retrieved 24 November 2023.
- "Corredor Interoceánico del Istmo de Tehuantepec: CONVOCATORIA A LA LICITACIÓN PÚBLICA INTERNACIONAL NÚMERO LPIBI-013AYH-PODEBI-7-2023 PARA EL ESTABLECIMIENTO DEL "POLO DE DESARROLLO PARA EL BIENESTAR CIUDAD IXTEPEC" EN EL ISTMO DE TEHUANTEPEC". Diario Oficial de la Federación (in الإسبانية). Mexico City. 30 October 2023. Retrieved 24 November 2023.
- "Corredor Interoceánico del Istmo de Tehuantepec: CONVOCATORIA A LA LICITACIÓN PÚBLICA INTERNACIONAL NÚMERO LPIBI-013AYH-PODEBI-8-2023 PARA EL ESTABLECIMIENTO DEL "POLO DE DESARROLLO PARA EL BIENESTAR MATÍAS ROMERO AVENDAÑO" EN EL ISTMO DE TEHUANTEPEC". Diario Oficial de la Federación (in الإسبانية). Mexico City. 30 October 2023. Retrieved 24 November 2023.
- "Corredor Interoceánico del Istmo de Tehuantepec: CONVOCATORIA A LA LICITACIÓN PÚBLICA INTERNACIONAL NÚMERO LPIBI-013AYH-PODEBI-9-2023 PARA EL ESTABLECIMIENTO DEL "POLO DE DESARROLLO PARA EL BIENESTAR SANTA MARÍA MIXTEQUILLA" EN EL ISTMO DE TEHUANTEPEC". Diario Oficial de la Federación (in الإسبانية). Mexico City. 30 October 2023. Retrieved 24 November 2023.
- ^ Gutiérrez Pacheco, Laura (7 October 2023). "Corredor Interoceánico: En esta fecha anuncian a las empresas ganadoras de las licitaciones de los parques industriales". Diario del Istmo (in الإسبانية). Retrieved 13 October 2023.
- ^ Olivares Alonso, Emir (22 December 2023). "Se sumarán dos polos de desarrollo a los 10 contemplados en el Corredor Interoceánico". La Jornada (in الإسبانية). Retrieved 22 December 2023.
- ^ "Corredor Interoceánico: ¿Qué empresas ganaron el primer paquete de polos de desarrollo?". El Financiero (in الإسبانية). 21 December 2023. Retrieved 22 December 2023.
- ^ Carbajal, Braulio (14 December 2023). "Presentan ProIstmo, organismo que impulsará el Corredor Interoceánico". La Jornada (in الإسبانية). Retrieved 8 March 2024.
- ^ López Cabrera, Heder (28 February 2024). "Corredor Interoceánico: coloca Proistmo primera piedra, tendrá seis vocaciones polo de Texistepec". Diario del Istmo (in الإسبانية). Retrieved 8 March 2024.
- ^ López Cabrera, Heder (26 February 2024). "Corredor Interoceánico: Polo de Texistepec será realidad ¿cuándo y a que hora inicia?". Diario del Istmo (in الإسبانية). Retrieved 8 March 2024.
- ^ "Fondo danés invertirá 10,000 mdd para hidrógeno verde en Corredor Interoceánico del Istmo". Forbes México (in الإسبانية). 24 November 2023. Retrieved 25 November 2023.
- ^ "Mexico president says Danish fund to invest $10 bln in Mexico to produce green hydrogen". Reuters. 24 November 2023. Retrieved 25 November 2023.
- ^ "Danish fund confirms green hydrogen project in Mexico". BNamericas. 18 August 2023. Retrieved 25 November 2023.
- ^ "Danish fund to invest US$10bn in Mexican green hydrogen plant". BNamericas. 25 November 2023. Retrieved 25 November 2023.
- ^ "Helax Istmo: Esta es la compañía detrás de la producción de energía renovable en el Corredor Transístmico". EL CEO (in الإسبانية). 22 December 2023. Retrieved 22 December 2023.
- ^ Valdelamar, Jassiel (27 July 2023). "Corredor Interoceánico la 'romperá' aportando hasta 5% del PIB: Raquel Buenrostro". El Financiero (in الإسبانية). Retrieved 1 August 2023.
- ^ Valdelamar, Jassiel (31 May 2023). "Corredor Interoceánico de AMLO y Canal de Panamá pueden ser 'compitas', destaca embajador". El Financiero (in الإسبانية). Retrieved 7 July 2023.
- ^ "Tren Interoceánico del Istmo de Tehuantepec se concluirá este año, anuncia presidente; modernización de puertos impulsará comercio con Asia". Presidente.gob.mx (in الإسبانية). 12 June 2022. Retrieved 8 August 2023.
- ^ أ ب Villarelo, J. (9 June 2023). "Corredor Interoceánico: detonante económico en comunidades pobres de Oaxaca". Excélsior (in الإسبانية). Retrieved 7 July 2023.
- ^ "Crecimiento económico por región: el Sur crece más que el Norte". El Economista (in الإسبانية). 18 September 2023. Retrieved 21 October 2023.
- ^ Yorio González, Gabriel (25 September 2023). "Cuando el sur-sureste crece, México crece más". El Universal (in الإسبانية). Retrieved 21 October 2023.
- ^ "Navy chief: Mexico to become "world shipping power"". Mexico News Daily. 1 June 2023. Retrieved 10 July 2023.
- ^ Chiñas, Sayda (8 July 2023). "Corredor transístmico beneficiará al mundo, destaca Adán López". La Jornada (in الإسبانية). Retrieved 12 July 2023.
- ^ أ ب Ortiz, Jimena (4 August 2023). "El Corredor Transístmico: ¿Espejismo u oportunidad?". El Economista (in الإسبانية). Retrieved 8 August 2023.
- ^ "Insuficiente infraestructura para gas natural atora éxito del nearshoring en México: IMCO". Forbes México (in الإسبانية). 15 August 2023. Retrieved 18 August 2023.
- ^ Corral Serrano, Carlos (8 August 2023). "Desafíos y obstáculos en la construcción del Corredor Interoceánico del Istmo de Tehuantepec". El Universal (in الإسبانية). Retrieved 8 August 2023.
- ^ أ ب Murray, Christine (16 October 2023). "Mexico revives century-old railway in $2.8bn bid to rival Panama Canal". Financial Times. Retrieved 20 October 2023.
- ^ González Díaz, Marcos (5 October 2023). "Qué es el Corredor Interoceánico con el que México quiere competir con el Canal de Panamá". BBC Mundo (in الإسبانية). Retrieved 20 October 2023.
- ^ Zavala, Juan Carlos (29 January 2023). "Por el impacto ambiental, comunidad del Istmo de Oaxaca rechaza obra del Corredor Interoceánico". El Universal Oaxaca (in الإسبانية). Retrieved 8 July 2023.
- ^ López Morales, Alberto (14 June 2023). "Puente Madera gana amparo que prohíbe al Corredor Interoceánico ejecutar un parque industrial en Oaxaca". El Universal Oaxaca (in الإسبانية). Retrieved 7 July 2023.
- ^ Díaz, Raúl (29 April 2023). "¿Qué pasó en Mogoñé Viejo? Marina, Guardia Nacional y pobladores se enfrentaron en Oaxaca". SDP Noticias (in الإسبانية). Retrieved 7 July 2023.
- ^ Briseño, Patricia (1 May 2023). "Liberan en Oaxaca a detenidos por supuesta obstrucción de trabajos del ferrocarril del Istmo". Excélsior (in الإسبانية). Retrieved 7 July 2023.
- ^ Manzo, Diana (7 September 2023). "Los otros datos de Corredor Interoceánico del Istmo de Tehuantepec". Pie de Página (in الإسبانية). Retrieved 1 December 2023.
- ^ Matías, Pedro (5 July 2023). "Hallan muerto al activista Noel López Gallegos, opositor al Corredor Interoceánico". Proceso (in الإسبانية). Retrieved 7 July 2023.
- ^ López Cabrera, Heder (12 July 2023). "Noel López Gallegos, activista en contra del Corredor Interoceánico fue asesinado: lo que sabemos del caso". Diario del Istmo (in الإسبانية). Retrieved 20 July 2023.
- ^ Rojas, Arturo (27 July 2023). "Reportan violaciones a DH por obras del Interoceánico". El Economista (in الإسبانية). Retrieved 1 August 2023.
- ^ "Ataques diferenciados a defensoras indígenas por construcción del Corredor Interoceánico del Istmo de Tehuantepec". SemMéxico (in الإسبانية). 28 July 2023. Retrieved 1 August 2023.
- ^ "MÉXICO | El Corredor Interoceánico: Una gran oportunidad eclipsada por el despojo | EL PAÍS". El País (in الإسبانية). 1 October 2023. Retrieved 25 November 2023.
- ^ López Morales, Alberto (28 November 2023). "Protestan en Oaxaca sobre vías del Tren Transístmico; exigen servicios para Salina Cruz". El Universal Oaxaca (in الإسبانية). Retrieved 1 December 2023.
- ^ "Corredor Interoceánico, entre inversión e impacto ambiental". Grupo Reforma (in الإسبانية). 15 November 2023. Retrieved 1 December 2023.
- ^ Valle, Ana (15 May 2019). "¿Quién es el empresario encargado del Corredor Transístmico?". Obras Por Expansión (in الإسبانية). Retrieved 9 July 2023.
- ^ Escobar, Julio (26 November 2022). "Rafael Marín Mollinedo deja la dirección del CIIT, asumirá la titularidad de Aduanas". Imagen del Golfo (in الإسبانية). Retrieved 9 July 2023.
أعمال مذكورة
- Gordon, Nicolas Edward (2013). FROM THE CRESCENT CITY TO JAGUAR HILL: NEW ORLEANS' BUSINESS INTEREST IN THE TEHUANTEPEC NATIONAL RAILROAD OF MEXICO, 1849 – 1861 (Master of Arts thesis). University of Oklahoma. doi:10.13140/RG.2.1.3537.4564. Retrieved 13 August 2023.
للاستزادة
- Ramírez, José F. (1853). Memorias, negociaciones y documentos, para servir a la historia de las diferencias que han suscitado entre México y los Estados-Unidos, los tenedores de; antiguo privilegio, concedido para la comunicación de los mares Atlántico y Pacífico, por el Istmo de Tehuantepec (in الإسبانية). Mexico: Imprenta de Ignacio Cumplido. Retrieved 4 December 2023.
وصلات خارجية
- Official website (in Spanish).
- Official websites of the Ferrocarril del Istmo de Tehuantepec (in Spanish):
- Pamphlets summarizing information regarding the CIIT, in English and Spanish.
- Pages using gadget WikiMiniAtlas
- CS1 الإسبانية-language sources (es)
- Short description with empty Wikidata description
- Coordinates on Wikidata
- Articles containing إسپانية-language text
- Pages using Lang-xx templates
- Articles with hatnote templates targeting a nonexistent page
- Pages using multiple image with auto scaled images
- Articles to be expanded from December 2023
- All articles to be expanded
- Articles with empty sections from December 2023
- All articles with empty sections
- Articles that mention track gauge 1435 mm
- برازخ أمريكا الشمالية
- جغرافيا المكسيك
- جغرافيا وسط أمريكا
- خليج المكسيك
- سواحل المكسيك
- اقتصاد المكسيك
- Trade routes
